After around ten years of delays and frustration, Auckland Transport are finally going to make Great North Rd greater.

In an update sent out yesterday, they said:

We are pleased to advise that we have appointed JFC Ltd to deliver the work and they’ll be starting work early January.

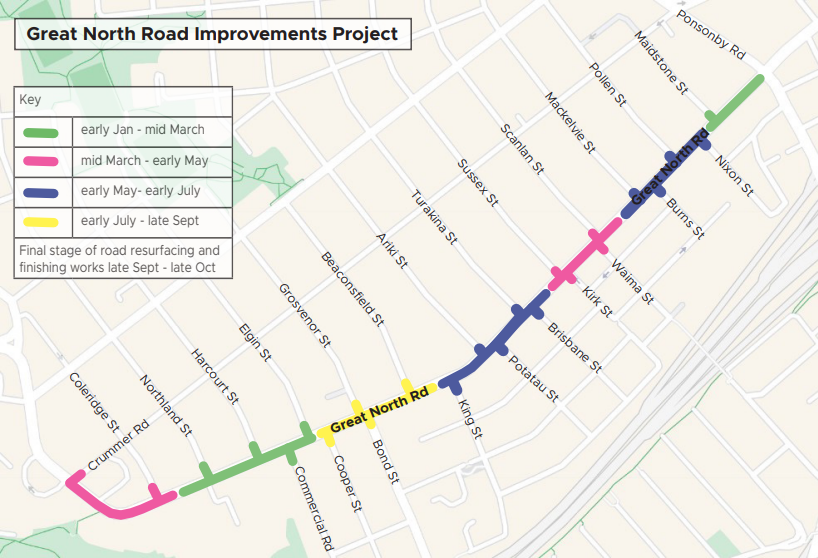

The entire project is expected to take less than 12 months, and to complete the work as quickly as possible we’ll stage the work along the route, working in two locations at a time (see staging map below). The first work areas are:

  • between Northland Street and Elgin Street
  • between Maidstone Street and Ponsonby Road

We are timing work at the busy Ponsonby Road end of the route during January-February when traffic volumes are lowest.

The government is making a lot of noises about the need to speed up the delivery of infrastructure around New Zealand, with a big focus on trying to deliver big projects. While there is absolutely room for improvement in the delivery pace of these, big projects also deserve big scrutiny. The government would do well to lend some focus to the much larger number of small projects that suffer from unnecessary delays – like as to why it takes nearly 10 years to deliver 1.6km of improvements, even or especially when the community supports it.

The long road to improving Gt North Rd

The first murmurings of this project were way back in 2014 with a series of planned improvements to intersections. Things really kicked off in 2015 when John Key announced the funded projects from his government’s Urban Cycleway Fund (UCF).

The UCF was one of National’s 2014 election promises, and would see $100 million of crown funding invested in cycling projects to be delivered by mid-2018. Combined with equal shares from the National Land Transport Fund and local government, this equated to nearly $300 million towards getting bike networks under way in cities around New Zealand. Gt North Rd was one of the projects included in the UCF.

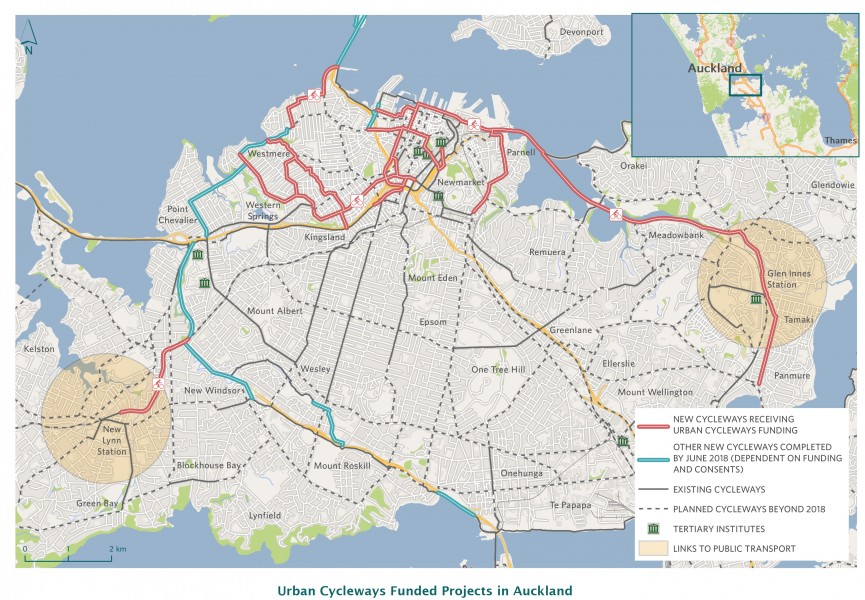

The plan for expanding Auckland’s cycle network, 2015-2018, thanks to the Urban Cycleways Fund.

In late 2016, AT consulted on designs for the corridor, which drew almost unanimous support: “Feedback showed overwhelming support for the proposed improvements on Great North Road with approximately 86% of responses being positive.”  AT noted: “We have some further investigatory work to complete, but expect to begin construction in late 2017“.

Progress continued to be made, and in 2017 they conducted another round of consultation.

But then, after a small amount of noisy opposition, AT got scared and the great cycleway freeze hit. AT paused most cycleway projects to review them – wasting years during a time with a government that was very supportive of exactly these kinds of projects.

During this time, AT incorporated the Gt North Rd project into its citywide Connected Communities multimodal corridor programme (which eventually quietly failed and folded last year, in what should have been a massive public debacle). The project design was tweaked as part of this, and in March 2021 – four and a half years after it was first taken to the public – the project was consulted on once again.

In July 2022, AT announced the project was finally happening:

Auckland Transport (AT) is delivering 1.6km of bus, safety, walking and cycling improvements along Great North Road, between Ponsonby Road and Crummer Road which will help move more Aucklanders along one of Auckland’s most iconic roads.

The changes will include safer crossings and intersections, a protected cycleway, extended bus lanes, longer loading zones for large vehicles (including car transporters), and more trees and landscaping.

Construction will take place from late 2022 till late 2023. Before major construction begins preparatory work is planned from August which will involve some minor work getting underway on the street.

Then the local body election happened, and managers delay merchants within Auckland Transport seized on grumblings from the mayor and local councillor as an opportunity to do what they do best, delay things further. It took a huge effort from advocates, community groups, and many locals, including schools, the residents’ association and the business association, to persuade the AT board to agree to proceed with the project.

The change in government late last year has seen a lot of changes in transport priorities, and I understand that a number of people both inside and outside of AT who oppose the project have tried to use this to try and relitigate the project once again.

With yesterday’s announcement, it seems the constant relitigation of this project is finally over. This is great – but it really shouldn’t take a decade to plan and deliver a much-wanted project that can be built in less than a year.
