Kiwirail and Auckland Transport have revealed that the rail network will be closed or partially closed for nearly 149 days between Christmas this year and the end of January 2026, almost 38% of the time, as part of what they’re calling the final push to get the rail network ready for the City Rail Link. That’s made up of 96 days of full closure and 53 days of partial closure.

The biggest of these will be the two Christmas shutdowns, each of which will be for about full month. It also appears they’ll be taking advantage of the short week between Easter and Anzac day to get another longer closure. The details of this year’s Christmas shutdown are below.

Christmas 2024 works includes a full rail network closure between 27 December 2024 to 27 January 2025. Parts of the network will be reopened on 28 January 2025, including the Western and Onehunga lines. There will be an additional week of service changes for the Southern and Eastern lines south of Otahuhu where buses will replace train. More on this will be released closer to the time.

The work being undertaken includes:

  • those associated directly with the CRL, like Henderson Station
  • projects like the third main between Otahuhu and Puhinui and new Southern Line Stations
  • completing the Rail Network Rebuild, which the government provided an extra $159 million for earlier this year
  • a bunch of other overdue renewals and upgrades which are funded out of Auckland’s $48.8 million share of a $107 million package in year’s budget (the Wellington is getting the remaining $58.2 million).

Putting aside the content, Kiwirail should clean this map up to make it more legible, for example, how about just three colours, Completed, In Progress, Upcoming

The press release also gets me a bit frustrated too:

Critical rail network upgrades being delivered before City Rail Link (CRL) opens in 2026 will support big cuts in journey times, fewer delays and trains every four to five minutes at peak.

Details were shared today on the transformational benefits coming for Aucklanders and the delivery plan for the network upgrade required before the opening in 2026. At the newly developed Maungawhau Station, Transport Minister Simeon Brown and Acting Auckland Mayor Desley Simpson, KiwiRail, Auckland Transport and City Rail Link Ltd shared the scale of what will be achieved between now and 2026.

Auckland Transport Director Public Transport and Active Modes Stacey van der Putten says everything is on track for opening in 2026, and Aucklanders can start to get excited about the new ways they will be able to travel around the city.

“CRL will bring quicker public transport journey times, it doubles the number of Aucklanders within a 30-minute train journey to the central city. Customers travelling from
the west will get the benefits of direct new connections, for example Henderson to the new Te Waihorotiu Station in the central city will be about 24 minutes quicker – just a 35-minute trip.

“Passengers will be able to just turn up and go with trains running more frequently – at peak, every four to five minutes through the central city, east and south from stations north of Puhinui Station. From the west there’ll be a train every eight minutes and from Pukekohe every 10 minutes.”

How the work will be delivered

“Additional funding provided by the Government in the latest Budget has allowed us to move forwards with certainty to plan and deliver much-needed upgrades on the rail network. These are essential to enable the faster, more frequent journeys that CRL and the other major projects we are delivering will bring,” says KiwiRail’s Chief Infrastructure Officer André Lovatt.

“The majority of the next and final stages of the Rail Network Rebuild will be delivered in extensions to the usual closures when all services are suspended during major holidays so our teams can safely work on the tracks and inside tunnels. This will include four weeks over Christmas 2024, and a couple of extended blocks around Easter 2025 and Christmas 2025 with some shorter periods of reduced frequencies on certain lines. A full network closure may not be needed for all those blocks, but this is the maximum time needed. There is also some contingency allowed throughout the programme for unexpected events.

“We know it’s vital to get the most out of this time period. That’s why we will be working 24-7 wherever possible. The hard work being achieved through Rail Network Rebuild is achieving a decade’s worth of work over 18 months – ultimately this will enable more efficient and faster train services. We thank commuters, passengers, and freight customers for their patience with these disruptions as we safely deliver the huge amount of work.”

This approach means relatively short sharp closures and less ongoing disruption when passengers and freight suppliers need the network most.

Talking about faster travel times is great but it’s notable that they continue to talk about travel times based on the current timetable. As we learnt and highlighted a month ago, there’s as much as five minutes of speed restrictions on some lines and even more time to be saved if AT were to speed up dwell times. I remain concerned that AT are not planning to incorporate these savings or make fixes to dwell times.

I’m also concerned that the Western Line, the one with the greatest travel time savings from the CRL, will get one of the smallest frequency improvements, going from six trains an hour at peak time to eight.

While these works are definitely needed, they are extremely frustrating and have been so frequent that most weekends my 3-year old will now say “there’s no trains, they’re fixing the tracks“. We’ve also had these long Christmas shutdowns for at least 20 years now. It would be good to get from Kiwirail confirmation of what their plans are once these are finished. Will we continue to see the network closed over summer and long weekends or will the closures we’ve had to put up with become much less frequent?

New Southern Stations

One of the wider network projects about to finally kick off is the building of the first of the new Southern Line stations, with Kiwirail saying:

We’re excited to announce construction is officially kicking off at Drury Railway Station in South Auckland, with our contractors expected to be on site from mid-November. It’s the first of the three new stations between Papakura to Pukekohe to start main construction.

They’ve also shown these renders of Drury and Paerata stations.

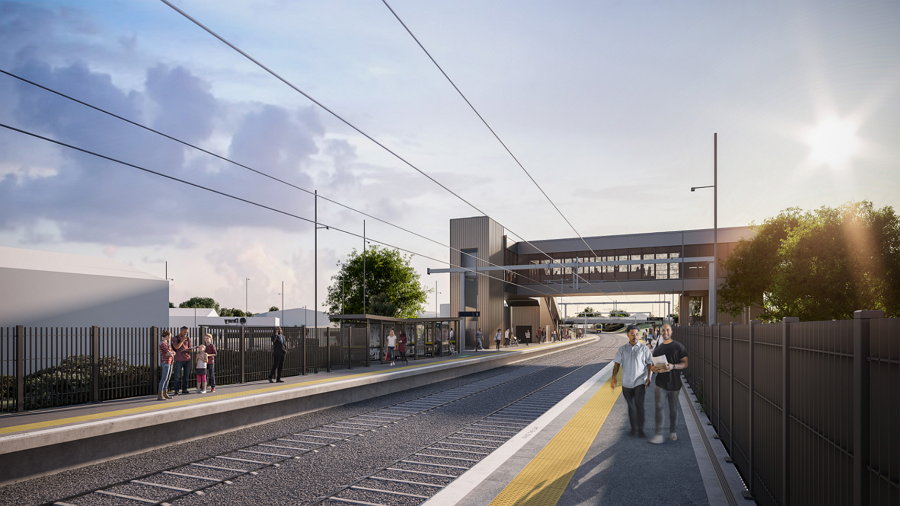

Artist’s impression of Drury Station

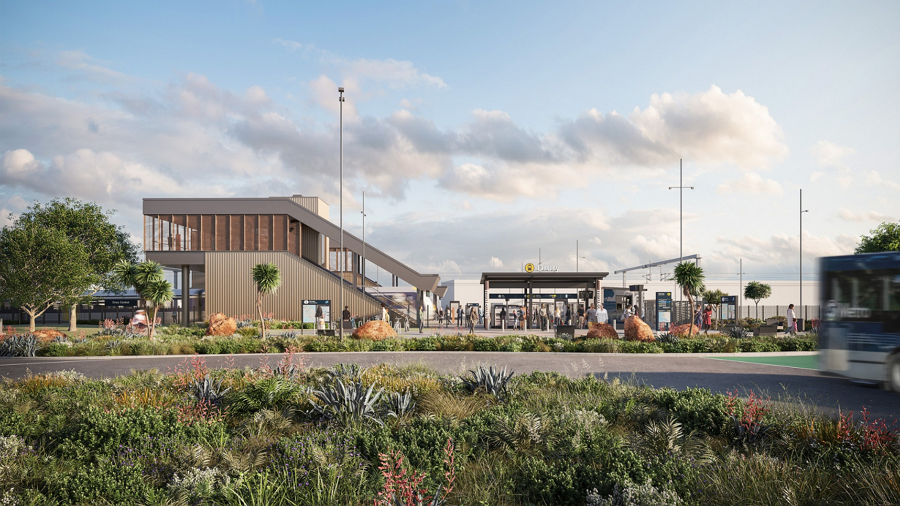

Artist’s impression of Drury Station

Artist’s impression of Paerata Station

We’ve been concerned about these stations for a long time due to costing around $500 million combined and that they seem to be designed entrench auto-dependency the greenfield areas being built nearby them.

If these renders are accurate, they raise that concern even higher. For half a billion dollars, it seems they’re getting very narrow platforms with just a few bus shelters for protection from the elements, not even the standard suburban station shelter design.

I guess they spent all of the money on the park and rides

Like with the question of why didn’t they fix the tracks while the line was closed for electrification works, I also wonder why they these stations weren’t built during the closure.
